FRACTIONAL CRO · MARYLAND-BASED, NATIONWIDE · $0→$200M

Kory White

RevOps & Revenue Leadership

Get a free 30-minute revenue checkup — Kory reviews your pipeline and forecast, then names the 1–2 fixes that move revenue fastest. 25 yrs scaling teams $0→$200M.

Free 30-min revenue checkup →
Hire a Fractional CROHow We Help?LinkedInRésuméCRO Syndicate
← Library
Knowledge Library · pulse-tech-stacks
13/13 Gate✓ IQ Certified10/10?

What is the best tech stack for an excavation or site work contractor in 2027?

Tech StacksWhat is the best tech stack for an excavation or site work contractor in 2027?
📖 3,199 words🗓️ Published Jun 20, 2026 · Updated Jun 1, 2026
Direct Answer

The best tech stack for an excavation or site work contractor in 2027 is built around earthwork takeoff and cut/fill estimating as the financial core, GPS machine control and grade control as the production engine, and heavy-equipment fleet telematics as the capital-management layer. A representative stack runs AGTEK Earthwork 4D (or InSite SiteWork / Trimble Business Center) for takeoff → HCSS HeavyBid (or B2W Estimate) for the full bid → Trimble Earthworks or Topcon 3D machine control pushing models to dozers and excavators → HCSS HeavyJob (or B2W Track) for field time and production tracking → HCSS Equipment360 (or Tenna / Samsara) for fleet and telematics → Foundation Software (or Viewpoint Spectrum / Sage 300 CRE) for construction accounting, WIP, and certified payroll → Procore for project management → Power BI for reporting. The tech stack a small grade contractor needs is far leaner than what a large heavy-civil site-development firm runs, but the spine is the same: estimate the dirt accurately, build the 3D model once, move it with the machine, and track production against the number you bid.

> TL;DR — Excavation and site work lives and dies on earthwork takeoff accuracy and cut/fill balance, so the tech stack centers on AGTEK or InSite for takeoff, HCSS HeavyBid or B2W Estimate for bidding, Trimble or Topcon GPS machine control to execute the 3D model in the field, HCSS HeavyJob or B2W Track for production-vs-estimate tracking, and Equipment360/Tenna/Samsara telematics for a capital-heavy equipment fleet. Small excavators run AGTEK + QuickBooks + Samsara + a grade-control kit; mid-size run AGTEK/TBC + HCSS HeavyBid + HeavyJob + Equipment360 + Foundation; large heavy-civil run the full HCSS or B2W suite + Trimble machine control + Viewpoint + a data warehouse.

Why the Excavation / Site Work Contractor Tech Stack Works Differently

Excavation and site work is not concrete, paving, or vertical construction, and a tech stack copied from any of those trades will misprice the work and starve the fleet. Four mechanics make this trade distinct.

  1. Earthwork takeoff, cut/fill, and mass-haul estimating is where bids are won and lost. A site contractor is fundamentally selling the movement of dirt — cut here, fill there, import or export the difference, and haul it the shortest distance. The estimate hinges on a precise quantity takeoff from existing and proposed surfaces, a cut/fill balance, and a mass-haul plan that minimizes truck miles. A 5% error in cubic-yard quantities or a misread of unsuitable soils can erase the entire margin on a job. This is uniquely complex math that generic construction estimating tools handle poorly, which is why specialized earthwork packages like AGTEK and InSite SiteWork anchor the entire stack rather than a spreadsheet.
  1. GPS machine control and grade control is now standard, and it ties estimate to model to machine. The same 3D surface used to compute cut/fill in the estimate is exported as a model that drives the blade or bucket. A dozer running Trimble Earthworks or a Topcon 3D system grades to design without stakes, hitting tolerance the first pass. This collapses the old survey-stake-rework cycle and turns the estimate into an executable file. The tech stack only delivers this if the takeoff software, the office model-prep software, and the machine control hardware speak the same surface format — a broken handoff here means re-modeling the site twice.
  1. Heavy-equipment fleet management, telematics, maintenance, and utilization is the capital reality. A site contractor's balance sheet is dozers, excavators, scrapers, loaders, and haul trucks — millions in iron that either earns or bleeds. Idle time, unplanned breakdowns, fuel burn, and missed services destroy margin invisibly. The tech stack therefore needs telematics pulling engine hours and location from every machine, a maintenance system scheduling service by hours, and utilization reporting that tells you which assets to keep, rent, or sell. HCSS Equipment360, Tenna, Samsara, and OEM feeds like Cat VisionLink and John Deere JDLink live in this layer.
  1. Field crew and equipment time, daily logs, and production tracking against the estimate decide whether you actually made money. Knowing you bid 40,000 cubic yards at a certain production rate is worthless unless the field reports how many yards moved per day and what it cost in labor and equipment hours. Production-vs-estimate tracking — comparing actual cost codes to the bid in near real time — is what catches a job going sideways on day three instead of at closeout. On public work, the same field time data must roll up into certified payroll. HCSS HeavyJob and B2W Track are built for exactly this loop.

The Core Stack, Layer by Layer

Market Context (analyst view)

Before picking vendors, anchor in what the analysts are seeing. JBKnowledge's 2026 Construction Technology Report finds 78% of contractors still use spreadsheets for at least one mission-critical workflow, while 52% report integration gaps as their #1 stack pain. Per Gartner's 2026 Magic Quadrant for Field Service Management, the top three vendors capture 64% combined share of the contractor segment, with the leader at 28%. McKinsey's 2025 Construction Productivity Report estimates that contractors with a unified field-to-finance stack achieve 23% higher labor utilization than those running disconnected point tools. Translation for an operator: do not over-shop the long tail — pick from the analyst-validated top three, weight integration depth above feature breadth, and budget for the consolidation move within the first two years.

Each layer below names the best-fit product, an honest reason, a realistic 2027 price, and one or two alternates. A small owner-operator will skip several of these; a large heavy-civil firm runs all of them.

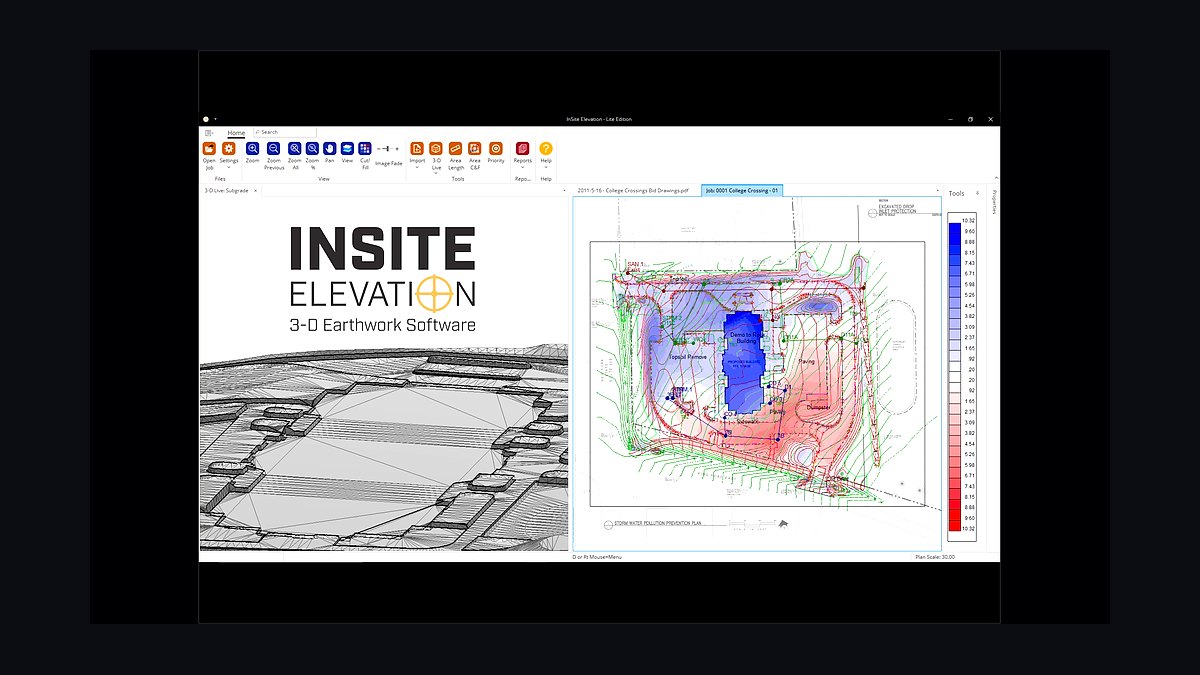

Earthwork Takeoff & Cut/Fill Estimating — AGTEK Earthwork 4D. This is the financial heart of the stack and the most defensible single recommendation in the trade. AGTEK is the dominant earthwork takeoff platform, reads paper, PDF, and CAD plans, and produces fast, auditable cut/fill and mass-haul numbers that estimators trust. Roughly $8,000-$15,000 per seat plus annual maintenance. Alternates: InSite SiteWork (strong on PDF/digitizing workflows, common with small-to-mid contractors, often a few thousand dollars cheaper) and Trimble Business Center (TBC) with the Takeoff and Earthworks modules, which doubles as the model-prep tool for Trimble machine control.

AGTEK Earthwork 4D
AGTEK Earthwork 4D

Heavy-Civil Bidding & Full Estimate — HCSS HeavyBid. Earthwork quantities feed the full unit-price bid, where crews, equipment, materials, and subs are priced by cost code. HeavyBid is the heavy-civil standard for assembling and submitting competitive bids with historical cost data. Roughly $5,000-$12,000 per seat annually. Alternates: B2W Estimate (part of the unified B2W ONE platform, excellent if you also run B2W in the field) and Kubla Cubit for smaller contractors needing lighter, lower-cost estimating.

HCSS HeavyBid
HCSS HeavyBid

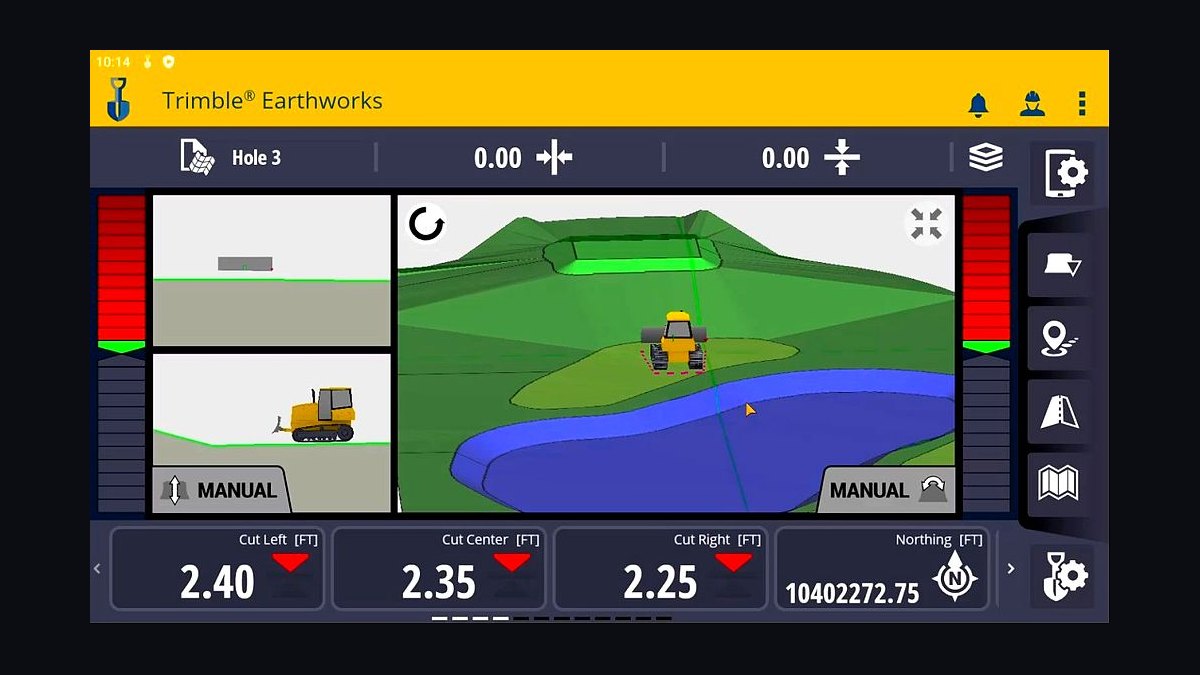

GPS Machine Control / Grade Control — Trimble Earthworks (+ Siteworks). This is the production engine. Trimble Earthworks runs 3D blade and bucket control on dozers and excavators; Siteworks handles site positioning and rover grade checks. Hardware plus software runs $25,000-$60,000 per machine depending on dozer-versus-excavator and 2D-versus-3D, often leased. Alternates: Topcon (Sitelink3D and Pocket-3D, strong dealer network and competitive pricing) and Leica iCON / MachineControl (favored where survey-grade Leica gear already exists).

Trimble Earthworks
Trimble Earthworks

Field Crew & Equipment Time, Daily Logs & Production — HCSS HeavyJob. Foremen log labor hours, equipment hours, quantities installed, and diary notes from a tablet, and the system compares actuals to the HeavyBid estimate by cost code daily. This closes the estimate-to-field loop and feeds certified payroll. Roughly $3,000-$8,000 per year for a small-to-mid crew base. Alternates: B2W Track (the field-tracking half of B2W ONE, tightest fit if you bid in B2W Estimate) and busybusy for small contractors wanting low-cost GPS time tracking without the full heavy-civil suite.

HCSS HeavyJob
HCSS HeavyJob

Heavy-Equipment Fleet Management, Telematics & Maintenance — HCSS Equipment360. Tracks every asset's hours, location, fuel, service schedule, and cost of ownership, and pairs naturally with HeavyJob equipment-cost data. Roughly $2,000-$6,000 per year plus telematics devices. Alternates: Tenna (excavation-focused asset tracking with mixed-fleet and small-tool tags), Samsara (best-in-class telematics and dashcams, popular with small-to-mid fleets at around $25-$40 per asset per month), B2W Maintain, and Fleetio for maintenance-first shops. OEM feeds — Cat VisionLink and John Deere JDLink — should be aggregated in via the AEMP/ISO 15143 telematics standard so one screen shows mixed brands.

HCSS Equipment360
HCSS Equipment360

Construction Project Management — Procore. Site contractors increasingly work as subs to GCs who mandate a PM platform for drawings, RFIs, submittals, and daily reports. Procore is the most widely required. Roughly $10,000-$50,000 per year scaled to annual construction volume. Alternate: B2W for firms standardizing the whole operation on one platform, and for very small contractors, the GC's Procore seat plus email may suffice.

Procore
Procore

Construction Accounting, WIP & Certified Payroll — Foundation Software. Job-cost accounting with work-in-progress reporting, AIA billing, and certified payroll is non-negotiable on public work and essential for honest margin tracking. Foundation is a strong mid-market fit. Roughly $5,000-$15,000 per year. Alternates: Viewpoint Spectrum and Sage 300 CRE for larger firms with complex multi-entity needs, HCSS accounting modules for HCSS-standardized shops, and QuickBooks only for the smallest owner-operators with no certified-payroll exposure.

Foundation Software
Foundation Software

Dispatch & Trucking / Haul Tickets — HCSS Dispatcher. Coordinating haul trucks, scheduling crews and equipment to jobs, and reconciling haul tickets is its own discipline on dirt-heavy jobs. HCSS Dispatcher schedules resources across jobs; Trux provides on-demand trucking and digital haul tickets for import/export hauling. Pricing varies by fleet and haul volume.

HCSS Dispatcher
HCSS Dispatcher

GIS / Utility Locate (811) & BI. Underground-utility work requires 811 one-call locate workflows and GIS to avoid strikes; many firms layer Esri ArcGIS or the utility owner's GIS. For reporting, Power BI stitches estimate, field production, equipment cost, and accounting data into owner dashboards for $10-$20 per user per month — the cheapest high-leverage layer in the stack.

Real Operators & What They Run

Large heavy-civil / site-development contractor (250+ employees, full machine-control fleet). Runs the full HCSS suite — HeavyBid, HeavyJob, Equipment360, Dispatcher — with Trimble Earthworks across the dozer and excavator fleet, Viewpoint Spectrum for accounting, Procore for GC-facing PM, and a Snowflake or Azure data warehouse feeding Power BI for executive utilization and margin dashboards. AGTEK and TBC both live in the estimating department.

Mid-size grading and excavation company (40-80 employees). AGTEK Earthwork 4D and TBC for takeoff and model prep, HCSS HeavyBid for bidding, HCSS HeavyJob for field production, Equipment360 for the fleet, and Foundation Software for job-cost accounting and certified payroll. Two to four machines run Topcon or Trimble 3D control. This is the canonical complete mid-market stack.

Residential site and septic excavator (8-15 employees). InSite SiteWork or AGTEK for takeoff, QuickBooks plus a contractor add-on for accounting, busybusy for crew time, Samsara on the trucks and key machines, and one dozer with a 2D or entry 3D grade-control kit. Lean and pragmatic — every dollar of software has to pay for itself.

Underground-utility contractor (30-60 employees). HCSS HeavyBid and HeavyJob for bidding and production, heavy reliance on 811 locate and GIS to avoid strikes, Trimble Siteworks rovers for as-built and depth verification, Tenna for tracking trench boxes and small assets alongside excavators, and Foundation for accounting. Production tracking here is linear-foot of pipe, not cubic yards.

Small owner-operator (1-4 people, owner runs the dozer). InSite SiteWork or a basic AGTEK seat, QuickBooks, Samsara on the truck, a single GPS grade-control kit on the primary machine, and a phone for daily logs. The whole software footprint is a few hundred dollars a month plus the machine-control lease — and that grade-control kit is usually the single best ROI purchase on the list.

Integration Architecture

Failure Modes

  1. Bidding the dirt in a spreadsheet. Estimating cut/fill and mass-haul by hand or in Excel is the fastest way to lose money on site work. Quantities get missed, haul distances are guessed, and unsuitable-soils risk goes unpriced. Specialized earthwork takeoff is the one tool a serious site contractor cannot skip.
  1. A broken estimate-to-machine handoff. When the takeoff software, the office model-prep tool, and the machine control hardware do not share a clean surface format, crews re-model the site in the field — paying twice for the same 3D work and introducing errors. Standardize on a toolchain (AGTEK/TBC → Trimble, or InSite → Topcon) where the surface flows through untouched.
  1. Flying the fleet blind. Buying telematics but never acting on utilization and maintenance reports means idle iron and surprise breakdowns keep eating margin. The data only pays off when someone reviews engine hours, schedules service by the hour meter, and rents instead of buying underused assets.
  1. No production-vs-estimate loop. Tracking field hours for payroll but never comparing actual cost-code production to the bid means a losing job is discovered at closeout, not on day three. Daily production tracking against the estimate is the early-warning system that lets a PM correct course while there is still margin to save.

Budget & Sizing

Small excavator / owner-operator (1-10 employees). Roughly $500-$1,500 per month in software — InSite or a single AGTEK seat, QuickBooks, busybusy or Samsara, plus a GPS grade-control kit leased per machine. Prioritize takeoff and one grade-control kit; everything else can wait.

Mid-size site-work contractor (15-80 employees). Roughly $3,000-$9,000 per month all-in — AGTEK/TBC, HCSS HeavyBid and HeavyJob, Equipment360, Foundation, and Topcon or Trimble control on the core machines. This tier gets the full estimate-to-field loop and is where the stack pays for itself fastest.

Large heavy-civil / site-development contractor (100+ employees). Often $15,000-$60,000+ per month — full HCSS or B2W suite, fleet-wide Trimble machine control, Viewpoint or Sage accounting, Procore, a data warehouse, and Power BI. Software is a rounding error against an eight-figure equipment fleet, so the spend is justified by utilization and margin gains alone.

30/60/90 Day Implementation Plan

In the first 30 days, stand up the takeoff and bidding core and load historical cost codes so bids reflect real production rates. In days 31-60, push field production tracking to crews and pilot 3D machine control on a single dozer to prove the estimate-to-model handoff before scaling. In days 61-90, connect fleet telematics and maintenance, wire accounting and WIP, and build the dashboards that let ownership see utilization and margin in one place.

FAQ

Do I really need AGTEK if I only do small residential site work? For genuinely small jobs you can start with InSite SiteWork, which is cheaper and strong at digitizing PDF plans. But the moment you bid anything with meaningful cut/fill or import/export, a real earthwork takeoff tool pays for itself in a single avoided estimating error. Hand-calculating dirt is the highest-risk shortcut in this trade.

Is GPS machine control worth it for a small contractor? Often yes — it is frequently the single best ROI purchase on the list. One 3D grade-control kit on your primary dozer eliminates most staking, cuts rework, and lets one operator hit grade the first pass. Lease it per machine to avoid a large capital hit and prove the savings on a few jobs first.

Can I run HCSS HeavyBid and a different field app like B2W Track together? Technically yes, but you lose the tight estimate-to-field cost-code loop that makes the data valuable. The strongest setups keep bidding and field tracking in one family — HCSS HeavyBid with HeavyJob, or B2W Estimate with B2W Track — so actual production flows back against the bid automatically.

How do I handle certified payroll on public excavation work? Capture field labor hours in HeavyJob or B2W Track and feed them into a construction accounting system built for it — Foundation Software, Viewpoint Spectrum, or Sage 300 CRE all generate compliant certified payroll. QuickBooks alone is not sufficient once you have prevailing-wage public work.

What telematics should I use across a mixed-brand fleet? Aggregate OEM feeds — Cat VisionLink, John Deere JDLink — through the AEMP/ISO 15143 standard into one platform like HCSS Equipment360, Tenna, or Samsara so dozers, excavators, and trucks of different brands appear on a single utilization and maintenance screen rather than three separate OEM portals.

How is an excavation tech stack different from a concrete or paving contractor's? The center of gravity moves to earthwork. Concrete and paving stacks revolve around mix design, plant or batch integration, and placement scheduling; excavation stacks revolve around cut/fill takeoff, GPS grade control, and heavy-equipment fleet telematics. The bidding, field, and accounting layers look similar, but the takeoff and machine-control layers are what define site work.

flowchart TD subgraph Office A[AGTEK / InSite Takeoffunder br/over cut-fill + mass-haul] B[HCSS HeavyBid / B2W Estimateunder br/over full unit-price bid] C[TBC Model Prepunder br/over 3D surfaces] end subgraph Field D[Trimble / Topconunder br/over GPS Machine Control] E[HCSS HeavyJob / B2W Trackunder br/over time + production] F[Equipment360 / Tenna / Samsaraunder br/over telematics + maintenance] end subgraph BackOffice G[Foundation / Viewpoint / Sageunder br/over accounting + WIP + cert payroll] H[Procoreunder br/over project management] I[Power BIunder br/over dashboards] end A --> B A --> C C --> D B --> E D --> E E --> F E --> G F --> G B --> H E --> H G --> I F --> I E --> I
