What is the best tech stack for a commercial plumbing contractor in 2027?
PULSEKNOWLEDGE LIBRARY
The best 2027 commercial plumbing stack pairs a pipe-aware estimating engine (Trimble AutoBid Mechanical or FastPIPE) with Procore for project management, Foundation Software or Sage 300 CRE for WIP and certified payroll, SysQue on Revit plus Navisworks for coordination and prefab spools, and BuildOps for the service and backflow division.
The scenario that exposes a mismatched stack
Picture a regional commercial plumbing contractor with 140 field staff, roughly $38 million in annual revenue, and a mix of hospital additions, mid-rise multifamily, and tenant fit-outs. The estimating department bids in a spreadsheet built by a since-retired chief estimator. Project managers track submittals in Outlook folders. The books run in QuickBooks with a bookkeeper hand-building a WIP schedule in Excel once a quarter for the bonding agent.
For years this holds together, because the market is forgiving and the chief estimator's gut is calibrated. Then three things happen in the same eighteen months. Copper and carbon steel prices swing hard enough that a bid priced in March is materially wrong by August. A general contractor standardizes on a model-based coordination requirement, so the plumbing sub has to deliver a clash-free Revit model or eat the field rework. And the company wins a $9 million hospital job whose schedule of values bills progressively with 10 percent retainage held to closeout.
The spreadsheet fails first. A 6-inch grooved carbon steel main and a 1-inch copper branch consume vastly different install hours per foot, and a flat per-foot rate averages them into a number that is wrong on both. On the hospital bid, the takeoff undercounts hangers and seismic bracing by a few hundred units, which reads as a rounding error on a spreadsheet line and lands as roughly 400 unbudgeted field hours. At a fully loaded $92 per hour, that is about $37,000 of margin evaporated before a single fitting is installed.
The accounting fails second, and more expensively. Front-loaded billing on the schedule of values means cash arrives early. The bank balance looks healthy through month seven. What nobody sees is that the job is 71 percent complete against 84 percent billed — a $1.1 million overbilling that is not profit, it is borrowed revenue from work still owed. Fade shows up at closeout as a swing from a projected 14 percent gross margin to 6 percent, discovered too late to recover through change orders.

The coordination failure is the quietest. Without a fabrication-accurate model, the shop builds a bathroom carrier rack off dimensions that ignore a duct main routed at the same elevation. Twelve racks arrive on site, none fit, and the crew field-modifies each one — roughly two hours per rack, plus the schedule slip. That single miss erases the entire labor savings the prefab program was supposed to deliver that quarter.
None of these are software problems in isolation. They are the predictable result of running a commercial plumbing business on tools designed for a smaller, faster, shorter-cycle trade. Every layer described below exists to close one of these specific gaps.
How the mechanism actually works
The stack is not a shopping list; it is a chain of custody for a single number. That number starts as a quantity in the takeoff, becomes a budget line in project management, becomes a spool ticket in the shop, becomes a labor hour in the field, and finally becomes a cost line in accounting. If the cost code breaks anywhere along that chain, you lose the ability to compare bid to actual — and without bid-to-actual, your labor units never improve and every future bid is the same guess.

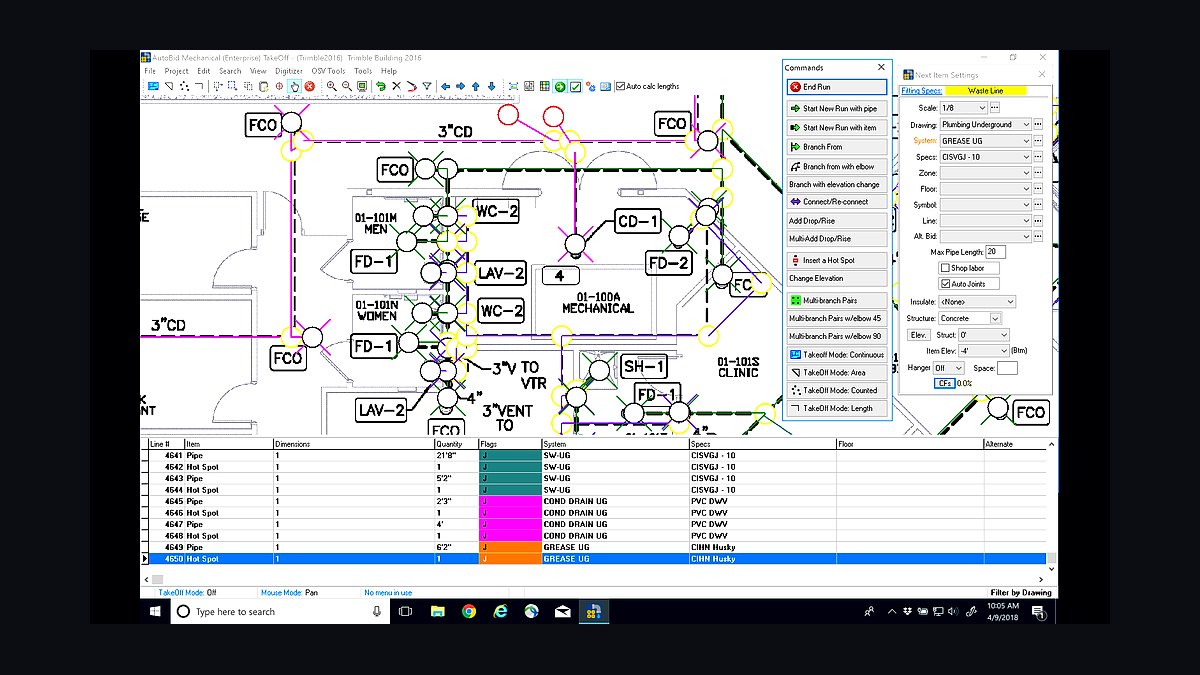

Start at the estimating layer. Trimble AutoBid Mechanical and FastPIPE both perform on-screen takeoff against PDF or digital plans, but the meaningful work happens after the count. Each item — 100 feet of 4-inch grooved steel, 46 grooved couplings, 8 butterfly valves, 62 clevis hangers — carries a labor unit from a tunable database. Industry labor units (MCAA, PHCC, or the tool's built-in library) are a starting point, not gospel. The whole discipline is adjusting those units against your own crews' actual production, which requires the field data to come back cleanly coded.
The takeoff exports as a budget with cost codes attached. Those cost codes are the spine of everything downstream. A workable structure for a plumbing contractor separates by system (sanitary waste and vent, domestic water, storm, gas, medical gas) and then by activity (rough-in, top-out, trim, test) — typically 30 to 60 active codes on a large job. Too few and you cannot diagnose where labor went; too many and the field stops coding accurately, which is worse than coarse data.
Procore receives that budget and becomes the system of record for RFIs, submittals, drawing revisions, daily logs, and change orders. The critical discipline is that change orders must flow back into the budget with the same cost codes. An approved change order that is not budgeted against a code shows up later as unexplained cost overrun on the base scope.
The model layer runs parallel. SysQue places manufacturer-real pipe and fittings inside Revit, so a 4-inch grooved tee in the model is a purchasable part with real dimensions, not a generic placeholder. Navisworks then runs multi-trade clash detection against the mechanical, electrical, and structural models. A clash resolved in the model costs a coordinator perhaps fifteen minutes; the same clash discovered above a finished ceiling costs a crew, a change order, and often a ceiling demo.

Once the model is clean, Trimble Fabrication generates spool tickets and cut lists. This is where prefab economics either work or do not. Shop-fabricated assemblies typically install faster than field-built equivalents because the shop has jigs, fixed workstations, and no ladder time — but only if the spool fits on the first try, which is entirely a function of coordination quality upstream.
Field time comes back through busybusy or Procore timecards, GPS-stamped and coded. That data does two jobs: it feeds certified payroll for prevailing-wage work, and it closes the loop on labor units. Foundation Software or Sage 300 CRE consumes the labor and material actuals, computes percentage-of-completion, reconciles over- and under-billings, tracks retainage, and produces the WIP schedule your surety and bank actually read.
The feedback arrow from dashboards back to labor units is the part most contractors never wire up, and it is the only mechanism by which estimating accuracy compounds over time.
Real numbers, ranges, and benchmarks
Pricing in this category is quote-driven and moves, so treat these as planning ranges rather than quotes. Estimating seats are the largest per-user line: Trimble AutoBid Mechanical commonly runs several thousand dollars per seat annually depending on modules, with FastPIPE typically positioned lower and easier to learn for mid-size shops. McCormick and Wendes sit below both and are reasonable for contractors under roughly $10 million in annual volume.

Bluebeam Revu is the cheapest high-leverage seat in the stack — low hundreds per user per year — and every estimator and project manager should have one. It is the lingua franca of markup between subs and generals, and refusing to buy it just means someone prints plans.
The Autodesk side comes as a collection: Revit plus Navisworks bundled in the AEC Collection, priced per seat annually, with SysQue licensed separately on top. A mid-size contractor typically starts with two to four coordination seats, not a department. Trimble Fabrication is quoted per shop and scales with workstations and machine integration; it is genuinely optional until you have a physical shop with dedicated fab labor.
Procore is volume-based, priced against your annual construction volume rather than seat count, which means it is meaningfully expensive for a mid-size sub and often the single largest software line item. This is the layer where "the GC already has Procore" is worth checking — many subs work inside the general contractor's instance at no license cost and only buy their own when they need their own document control, financials, and multi-project portfolio view.
Construction accounting scales by user count and module. Foundation Software is the common mid-market answer; Sage 300 CRE serves larger firms; Viewpoint Spectrum sits at the enterprise end; Jonas Construction positions as all-in-one. Knowify is the lightweight option for small shops that want real job costing without an enterprise implementation.

Field service software for the service and backflow arm is priced per technician per month, and it is worth noting that BuildOps and ServiceTitan Commercial both target the commercial trade specifically — the residential-first products in this category do not handle service agreements, multi-site customers, or backflow certification workflows the same way.
Useful sizing benchmarks, by company shape:
Small commercial shop, under 30 field staff: one or two estimating seats, Bluebeam, a light job-cost-plus-service platform, QuickBooks with an outside accountant building WIP, GPS time tracking. No fab shop, no enterprise PM. Software lands in the low thousands per month.

Mid-size contractor, 80 to 200 field staff: a three-to-six-seat estimating department, two to four SysQue and Revit seats, Procore, Foundation or Sage 300 CRE, BuildOps for a growing service arm, field time tracking across all crews, Power BI for backlog and fade. Software becomes a managed budget line in the five figures monthly.
Large mechanical and plumbing enterprise, 300-plus staff: estimating across a department, a full fabrication shop with Trimble Fabrication and dedicated VDC staff, Procore enterprise, Spectrum or Sage 300 CRE, ServiceTitan Commercial or BuildOps at scale, and an internal BI function.
As a planning heuristic, construction software commonly lands somewhere in the range of a fraction of one percent to roughly one percent of annual revenue for contractors running a full stack. If you are far below that and running long contracts, you are almost certainly absorbing the cost as unmeasured labor and margin fade instead.
The operational benchmarks that matter more than price: bid-hit rate by estimator and by GC, labor units actual versus estimated by system and phase, percentage of installed value that came through prefab, days sales outstanding split between progress billing and retainage, and fade — the delta between projected margin at 50 percent complete and realized margin at closeout. Fade is the single most diagnostic number a commercial plumbing contractor tracks, and no tool produces it unless the estimate-to-budget-to-actual chain is intact.

Trade-offs and alternatives
Every layer here has a defensible cheaper alternative and a defensible reason to skip. The judgment is knowing which trade you are actually making.
AutoBid Mechanical versus FastPIPE. AutoBid has the deeper labor library and tighter integration into Trimble's fabrication and field-layout tools, which matters enormously if you intend to run prefab as a real program. FastPIPE is faster to learn, lighter to administer, and frequently the better answer for a shop with two estimators and no fab shop. The trade is ecosystem depth versus time-to-productivity. If you will never buy Trimble Fabrication, AutoBid's integration advantage is theoretical.
Procore versus the GC's instance versus Autodesk Build. Procore's value to a subcontractor is portfolio-level document control and financials across all your jobs. If you have four active projects and every general contractor already runs Procore, working inside their instances costs you nothing and covers the project-level workflow — you lose the cross-project view and your own historical record. Autodesk Build is the natural alternative if your coordination team already lives in Autodesk Construction Cloud, since the model and the project data share a home.
Foundation versus Sage 300 CRE versus staying on QuickBooks. QuickBooks is genuinely adequate for a plumbing contractor doing short-cycle service work and small tenant jobs. It stops being adequate the moment you have multi-month contracts with retainage and progressive billing, because it cannot honestly produce percentage-of-completion revenue recognition or an over/under-billing schedule. The bright line is not revenue — it is contract duration and retainage. A $6 million service business is fine on QuickBooks; a $3 million business running two nine-month contracts is not.

BIM in-house versus subcontracted coordination. Standing up SysQue, Revit, and Navisworks means seats, training, and at least one person whose job is coordination. Below a certain project volume, hiring a coordination consultant per project is cheaper and faster. The tipping point is roughly when you have continuous model-based work rather than occasional jobs — a coordinator with nothing to coordinate is expensive idle capacity.
Prefab now versus prefab later. Fabrication software without a shop is shelfware, and a shop without coordinated models produces racks that do not fit. These two investments must land together or neither pays. The honest sequence is: coordinate models well for two or three projects, prove your model accuracy against field conditions, then invest in the shop and the fabrication software.
Separate service platform versus forcing service through the project stack. Running dispatch, service agreements, and backflow certification tracking through a construction PM tool fails because the data models are different — service is customer-and-asset centric with recurring obligations, projects are contract-and-schedule centric. The counter-argument is one fewer system and one fewer integration. That argument loses as soon as backflow test-due dates carry compliance consequences with the local water authority.
Common pitfalls and how to avoid them
Buying a generic estimator instead of a piping-aware one. Flat-rate price books and per-square-foot spreadsheets cannot represent the cost difference between materials and diameters, and they cannot be tuned against your crews. Avoid it by making material-and-diameter-aware takeoff a hard requirement in any evaluation, and by testing candidate tools on a job you already built — if the tool's estimate does not land near your known actual, its labor library is wrong for you and needs tuning before you bid live work with it.

Letting cost codes drift between systems. The estimate uses one structure, Procore's budget uses another, and accounting uses a third inherited from 2011. The result is that bid-to-actual comparison becomes a manual reconciliation nobody has time for. Avoid it by defining the cost-code structure once, before any implementation, and making every system inherit it. This is unglamorous and it is the highest-leverage day of the entire rollout.
Running long contracts without true WIP. Progress billing ahead of production creates cash that reads as profit. Without an over/under-billing schedule you will not see fade until closeout. Avoid it by producing a WIP schedule monthly — not quarterly for the bonding agent — and by reviewing percent complete against percent billed on every active job in the same meeting.
Estimating in a vacuum. If field hours never come back coded, labor units never get corrected, and the estimating department is permanently working from an unvalidated library. Avoid it by running a post-job review on every project above a threshold, comparing estimated versus actual hours by system and phase, and feeding corrections back into the estimating database on a scheduled cadence.

Prefab without coordination, or coordination without prefab. Spools built off an uncoordinated model do not fit; models coordinated for jobs that get field-built waste the investment. Avoid it by sequencing coordination first, measuring model accuracy against as-built conditions, and only then funding the shop.
Treating the service and backflow arm as an afterthought. Service revenue is recurring and higher-margin, but it evaporates when test-due dates are tracked in a spreadsheet and renewals are nobody's job. Avoid it by giving the department its own platform, its own P&L inside the accounting system, and a named owner for agreement renewals.
Rolling everything out at once. Simultaneous estimating, PM, accounting, and coordination implementations compete for the same handful of people who understand your business. Avoid it by sequencing: accounting and cost codes first, then estimating, then project management, then coordination, then fabrication and service. Roughly a quarter per major layer is realistic for a mid-size contractor.
Ignoring the integration burden. Every system boundary is a place data stops flowing. Before signing anything, ask specifically how the estimate exports to the budget, how the budget reaches accounting, and how field time reaches payroll. If the answer to any of those is a CSV someone exports monthly, price the labor of that CSV into the total cost of ownership.
Related questions
How is a commercial plumbing stack different from a residential one?
Residential runs on flat-rate pricing, dispatch, and same-day cash collection. Commercial runs on material-and-diameter takeoff with labor units, months-long contracts with retainage, model-based coordination against other trades, and prefab. The tools barely overlap outside of accounting basics.
Do I need Procore if all my general contractors already use it?
Often not at first. Working inside each general contractor's instance covers project-level RFIs, submittals, and drawings at no license cost. You buy your own once you need cross-project document control, your own financial record, and portfolio-level visibility your generals will never give you.
What should I implement first if I can only afford one thing?
Construction accounting with true WIP, retainage, and certified payroll. It is the only layer that tells you whether you are actually making money. A great estimate you cannot validate against actual cost is a guess with better formatting.
How do I handle prevailing-wage and public work?
Certified payroll is produced by the accounting system, not a separate tool, and it depends entirely on field time being captured by cost code and classification. Get the time-tracking-to-payroll path working before you bid public work, not after you win it.
When does a prefab shop actually pay for itself?
When you have enough continuous, coordinated, repeatable scope — bathroom carriers, riser assemblies, equipment racks — to keep the shop loaded. Sporadic prefab carries the fixed cost without the throughput, which is why coordination maturity should precede the shop investment.
FAQ
Can I bid commercial plumbing work in Excel?
Below a few hundred thousand dollars of commercial work, sometimes. Past that, a spreadsheet cannot apply differentiated labor units by material and diameter, cannot be audited by a second estimator, and cannot feed a budget with cost codes. The failure mode is not obvious — you win the jobs you underbid.
What is the single most important tool in the stack?
The estimating and takeoff engine, with construction accounting a close second. The estimate sets your margin; the accounting tells you whether you earned it. Everything else — project management, coordination, fabrication, field time — optimizes throughput between those two.
Should the service and backflow division share software with the project side?
No. Project work is estimate-and-schedule driven; service is dispatch-and-renewal driven with compliance deadlines on backflow certifications. Run a dedicated commercial service platform, track the department's P&L separately, and consolidate financials in the accounting system.
How long does a full stack implementation take?
For a mid-size contractor, plan on a year, sequenced roughly a quarter per major layer: accounting and cost codes, then estimating, then project management, then coordination and service. Compressing it into a single quarter reliably produces a half-configured system nobody trusts.
Is BIM coordination worth it if my general contractors do not require it?
Increasingly yes, because it prevents field rework whether or not anyone mandates it. But if model-based work is occasional, subcontract coordination per project rather than buying seats and hiring a coordinator you cannot keep busy.
What metric best tells me the stack is working?
Fade — the difference between projected margin at midpoint and realized margin at closeout. Shrinking fade means your labor units are calibrated, your change orders are captured, and your cost codes survive the trip from estimate to actual. It is the one number that indicts every broken link at once.
